Fred is the project manager of the NHA project. This project has a BAC of $2,456,900 and is sixty percent complete. Fred has crashed the project, which has driven the project costs to date to $1,525,140, but his project is five percent more complete than what was planned. What is the cost variance for this project that Fred needs to report to management?
You are the project manager for your organization. You and the project team are developing the project schedule for your current project. In addition to the enterprise environment factors and the organizational process assets, you will need seven other inputs to this process. Which one of the following is NOT an input to the Develop Schedule process?
Mark is the project manager of the GHQ Project. He is happily reporting that his project has a schedule performance index of 2.12. Management, however, does not think this is good news. What is the most likely reason why management does not like an SPI of 2.12?
George is the project manager of the NHQ Project and has a budget of $778,000. The project is scheduled to last for one year with an equal amount of work completed each quarter. The second quarter of the project has ended and George has spent $325,000 but has only finished forty percent of the project. Management needs a variance report for the project schedule. What value should George report in this instance?
Fill in the blank with an appropriate phrase.
The __________ includes a description of any collateral services required, such as performance reporting or post-project operational support for the procured item.
Andy works as the project manager for Bluewell Inc. He is developing the schedule for the project. There are eight tools and techniques that a project manager can use to develop the project schedule. Which of the following is a tool and technique for the Schedule Development process?
Which organizational theory explains the factors that promote performance of people in any organization?
You work as a Project Manager for Dreams Unlimited Inc. You are looking for performance efficiencies of a project. The related key values are provided in the table below:
MeasurementsValues
BCWP (or EV)325
BCWS (or PV) 300
ACWP (or AC)410
What will be the cost performance index (CPI) of the project at the current point of time?

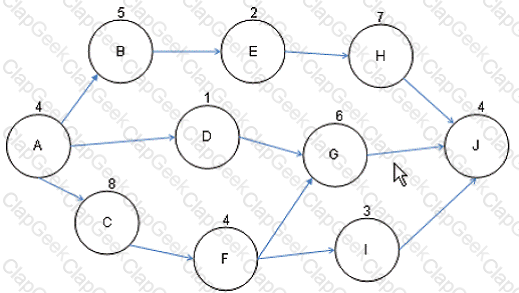

You are the project manager of the NHQ Project. You have created the project network diagram as shown in the figure:
You are concerned about a risk on Activity G that if it happens will delay the project by four days. You would like to utilize float for Activity G. How much float is available for Activity G to help offset the risk event?
Laura is the project manager for her organization and management has requested her to create a report on her project's performance. Laura needs to analyze her current project performance and then compare it against what, in order to create a performance report?
Amy is working on a project which is forty percent complete though it was scheduled to be fifty percent complete as of today. Management has asked Amy to report on the schedule variance for her project. If Amy's project has a BAC of $750,000 and she has spent $485,000 to date, what is the schedule variance value?

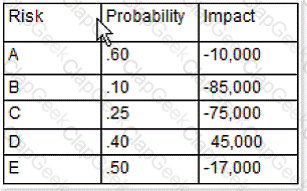

You are the project manager of the GHE Project. You have identified the following risks with the characteristics as shown in the following figure:
You work as a project manager for BlueWell Inc. Some of the activities in your project are not being completed on time. You review these activities with your project team discovered that the time estimates for the project are much more aggressive than what they are actually experiencing in the completion of the activities. You decide on to create a new schedule for the project. What project management process are you working with when you create a new target schedule?
Samuel works as a project manager in Bluewell Inc. He is performing constructability analysis in one of the initial planning phases. Which of these does constructability take into account during analysis? Each correct answer represents a complete solution. Choose three.
You are the project manager of the GHY Project. This project is scheduled to last for one year and has a BAC of $4,500,000. You are currently 45 percent complete with this project, though you are supposed to be at your second milestone which accounts for half of the project completion. There have been some errors in the project which has caused you to spend $2,073,654. What is this project's schedule performance index?
Fill in the blank with the appropriate word. ____ management sets the boundaries for the project and is the foundation on which the other project elements are built.
Which of the following documents captures and defines the work activities, deliverables, and a timeline that a vendor will execute against in performance of work for a customer?
Which of the following components of the change control system includes the documentation, tracking systems, and defined approval levels necessary for authorizing and controlling changes?
A construction company is about to start a new project. It requires hiring a project manager for this project. Which of the following are the most important skills that a person must have to be selected as a project manager?
You are the project manager of a project that has a budget of $675,000 and you have completed 40 percent of the project work. Your project is supposed to be 60 percent complete but you are actually only 40 percent complete. Due to some errors, however, you have actually spent $335,000 of the budget. Management wants to know what the project's cost performance index (CPI) is. What value do you report?
Which of the following are the inputs to the Develop Project Charter process? Each correct answer represents a complete solution. Choose all that apply.
You are the project manager of the NHA Project. This project is expected to last one year with quarterly milestones throughout the year. Your project is supposed to be at the third milestone today, but you are likely to be only 60 percent complete. Your project has a BAC of $745,000 and you have spent $440,000 of the budget-to-date. What is your schedule variance for this project?
You are the project manager of the GUH project. You are using the critical chain scheduling method as your approach to project scheduling. What two items can you compare in the critical chain method to determine if corrective action is appropriate?
You are the project manager of a research project. Because much of the project work will be based on what is discovered in each stage of the project work, you are directing the project time to focus on creating time estimates for the most imminent research work and broad estimates for the project work that is coming later in the project. What type of planning are you using in this project?
You are the project manager of the NHA Project. This project is expected to last one year with quarterly milestones throughout the year. Your project is supposed to be at the third milestone today, but you are likely to be only 60 percent complete. Your project has a BAC of $745,000 and you have spent $440,000 of the budget-to-date. What is your cost variance for this project?
You are the project manager of the QAQ Project. The QAQ Project has a BAC of $2,786,121. You are currently 20 percent complete with this project, though you should be 25 percent complete with the project work. The project has consumed $595,000 of the project budget to date. Management has asked you, based on the current project performance, what the project's estimate to complete will be considering the current project schedule variance. What is the ETC for this project?
You are the project manager for your organization. Management has offered you a bonus if you can complete the project work two months earlier than what your schedule predicts. You can use a schedule compression technique, but management does not want to increase costs in the project. What approach would you recommend to condense the project duration?
You are the project manager of the NHQ project. This project is slightly larger than the TR project, in which you also served as the project manager. You decide to use the actual activity duration of the GTR project as a basis for your current NHQ project. This, you reason, will save time for your project, as the previous project has provided the information. Which one of the following terms best describes the action you are doing in this scenario?
Gary is the project manager of the NGH project for his organization. He and the project team have created the initial WBS. Before Gary and the project team begin creating the activity list, Gary wants the project team to help him create a unique numbering system for the deliverables identified in the WBS. What numbering system can Gary and the project team apply to the WBS to identify the components of the WBS?
Ned is the project manager of the HYQ Project. In Ned's project, the management has requested that he enforce resource leveling so that the maximum amount of hours in the project per worker will not exceed 25 hours per week. Ned's pay is based on how quickly he can complete the project work. What must Ned do to accommodate the change in the resource allotment if he has to finish the project on time?
You work as a project manager for BlueWell Inc. You are calculating the performance indexes of your project. The cost variance (CV) of your project is 30. What does this figure depict?
You are the project manager of the NHQ project. Your project has a budget of $1,258,456 and is scheduled to last for three years. Your project is currently forty percent complete though it should be forty-five percent complete. In order to reach this point of the project, you have spent $525,000. Management needs a performance report regarding the NHQ project. What is the planned value for this project?
You are the project manager of the SWC project. You have created the stakeholder register. In the stakeholder register of your project, you will have all of the following information except for which one?
You are the project manager of the NHQ Project. This project has a Budget at Completion of $750,000 and is expected to take 18 months to complete. The project is supposed to be 75 percent complete, but due to some errors the project is only 60 percent complete. At this time the project has spent $465,500. Management has asked you to review the project work and report the project's SPI. What is the SPI for this project?
You work as a Project Manager for Dreams Unlimited Inc. You are looking for performance efficiencies of a project. The related key values are provided in the table below:
MeasurementsValues
BCWP (or EV)325
BCWS (or PV) 300
ACWP (or AC)410
What is the schedule variance (SV) of the project at the current point of time?
Your project is installing 8,000 light fixtures in a new building. Each of the light fixtures is to be installed exactly the same way but you have discovered that some of the fixtures are installed incorrectly. You and the project team meet and agree to fix the fixtures and to install all future fixtures the same way. This is an example of what executing activity?
Frank is the project manager in BlueWell Inc. He is working with his project to subdivide the project work packages into smaller, more manageable components. He and the project team are planning in detail all of the things the team will need to create, purchase, or do in order to satisfy the project scope. Management is concerned with the activity which Frank is using in this scenario, as they believe that Frank is taking too long to complete this pre-execution activity. Which of the following techniques of the activity process is Frank using in this example?
You are the project manager of the GHY Project. This project is scheduled to last for one year and has a BAC of $4,500,000. You are currently 45 percent complete with this project, though you are supposed to be at your second milestone, which accounts for half of the project completion. There have been some errors in the project, which has caused you to spend $2,073,654. What is this project's planned value?
You are the project manager of the NHQ project. Your project has a budget of $1,258456 and is scheduled to last for three years. Your project is currently forty percent complete though it should be forty-five percent complete. In order to reach this point of the project, you have spent $525,000. Management needs a performance report regarding the NHQ project. Management is concerned that this project will be over budget upon completion. Based on the current performance value what should you report to management regarding the variance at completion?
You are the project manager for your organization. You are working with your virtual team to create activity duration estimates for your current project. This virtual team is comprised of team members from around the world. Much of this process will be completed by geographical locations though some conferences will require all the team members to participate and to coordinate the activities that will interact between the different sites. The project manager must consider all of the following when creating the activity duration estimates except for which one?
You are the project manager of the NHQ Project. You are coaching Alice, a new project manager, on the relationships in a project network diagram. Which relationship type between activities are the most common?
